Downspout disconnection jobs: checks in Toronto, Vancouver, Montreal

Downspout disconnection jobs in Toronto, Vancouver and Montreal: what to confirm before you quote, how one house becomes three jobs, and what to document.

What to take away

  • Quote disconnection by city, not by pipe length. Permit effort, inspection risk and follow-up visits vary more than the downspout does.
  • In Toronto, disconnection is mandatory for property owners, so the job is a capped connection, a safe discharge point and a record of both.
  • In Vancouver, roof water goes to infiltration, storage or controlled release on site, so the job needs a place for the water to go.
  • Montreal has no citywide rule. Each borough sets its own permit and method, so a Plateau job and a Verdun job are not the same job.
  • Written scope and dated photographs protect the homeowner and the contractor.

Why the pipe is the cheap part

A connected downspout drops clean roof water into the sewer, and in a storm that water fills the pipe and basements flood. Cities regulate the connection for that reason, so the contractor's real work is the permit, the discharge point and the follow-up.

Municipalities hold authority over connections, so a downspout is not a purely private pipe: Toronto's page says it is mandatory for all property owners to ensure their downspouts are disconnected from the City's sewer system.

The pipework is nearly identical in all three cities. What changes is who requires the work, where the water may go and what must be kept on file. Check those three things before any number goes to the owner.

The rules also create steady work. A disconnection notice or a flood claim ends with someone calling a contractor, and regulated cities reward crews who know the local rule. That demand is what makes these cities worth entering.

For what the bills and subsidies look like in each city, see the stormwater and water-rate comparison.

The pre-quote checks, city by city

Run the same five checks on every job, then record the answer for the city in front of you. The table shows what the answers look like in each place.

CheckTorontoVancouverMontreal
Who requires the workProperty owners, by city ruleThe city's rainwater management approachThe borough, not the city
Where the water goesOnto the property, to grass or a garden areaInfiltration, storage or controlled releaseWhere the borough allows, with winter ice in mind
What to ask the cityWhether a Plumbing Permit appliesWhether the site needs a rainwater planWhich permit and method the borough accepts
What to keepPhotographs of the capped connectionPhotographs and the overflow pathThe permit and the borough answer in writing
What can go wrongA hazardous or infeasible disconnectionA blocked infiltration pointA shared downspout or a flat roof

Ask for each answer in writing where the city or borough will give one. A permit name or a method accepted in one place may be refused in the next.

Toronto: a mandatory job with a paper trail

Toronto's rule defines the job: the owner is obliged, and the contractor does the work and leaves proof.

The rule sits in Toronto Municipal Code Chapter 681, Sewers. The code prohibits clean roof water in the sanitary sewer. Enforcement is complaint-driven and inspection-driven, so not every house gets a letter.

A typical job has four steps. Confirm the existing connection, cap the open pipe that remains when the downspout is removed, extend the downspout toward a grassed or garden area, and photograph each stage. The city also says to cap the sewer connection so debris stays out.

Older housing stock and mature tree canopy mean downspouts are often undersized, broken or buried. Disconnection turns into a repair more often than not.

The Basement Flooding Protection Subsidy Program pays up to $1,750 for downspout disconnection, with a pre-inspection required. Tell the owner before the quote, because the pre-inspection comes first.

A Plumbing Permit from Toronto Building may be required if the work alters the drainage connection. Check with the city before you schedule the crew, because the wrong permit slows the job and eats the margin.

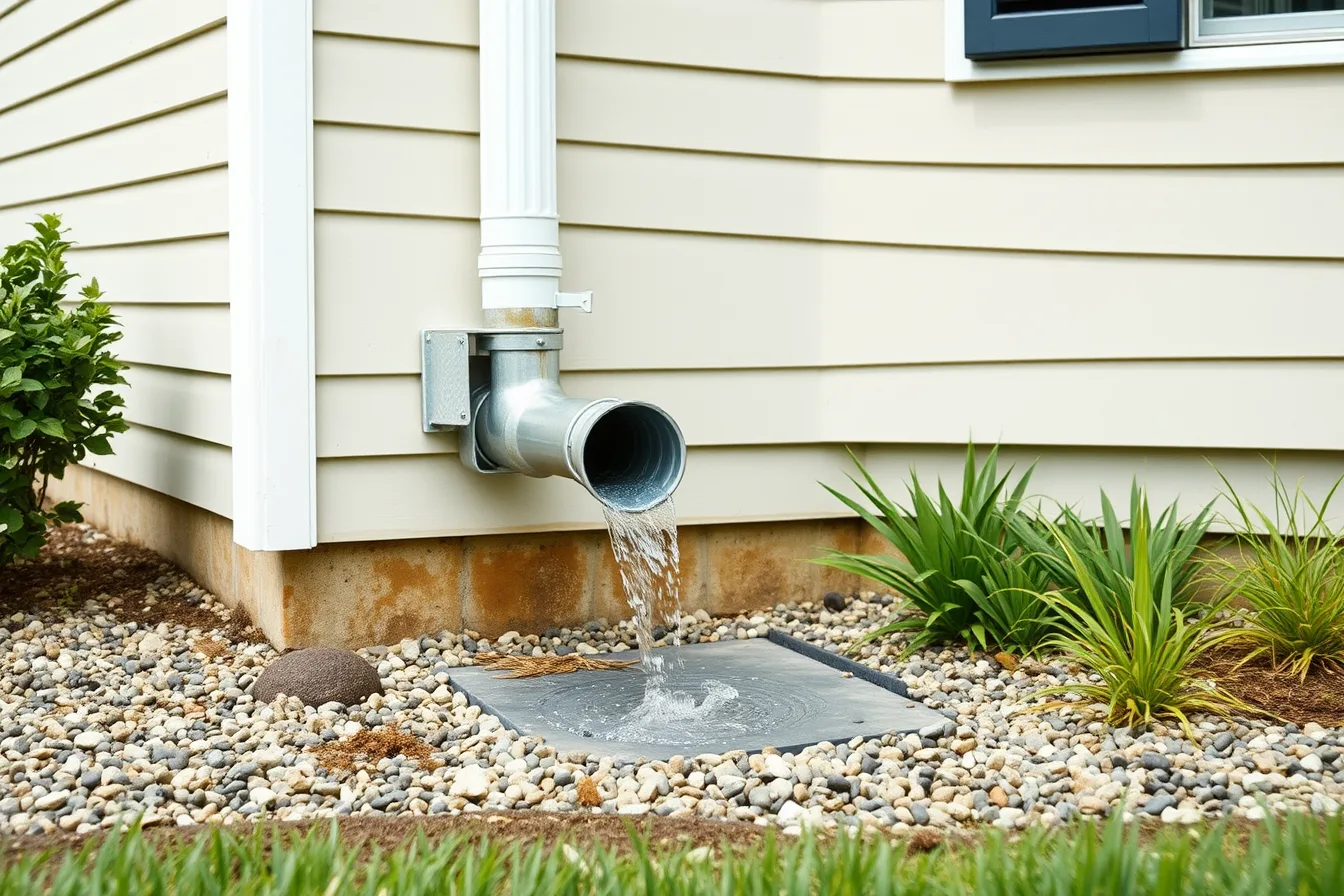

Vancouver: find the water a place to go

Vancouver handles the same problem through rainwater management on site, not a single disconnection rule. The city wants rainwater managed by infiltration, storage or controlled release, and disconnection is one tool inside that approach. The requirements sit in the Waterworks By-law No. 4844 and the city's Rainwater Management Bulletin.

On a single-family lot, that usually means sending roof water to a landscaped area, a rain garden or a tank. On larger sites the city may ask for a rainwater management plan showing how runoff moves across the property. Whether your site needs one is a question for the city and, where structure is involved, a licensed engineer.

The coastal climate changes the maintenance pattern. Moss, needle debris and rain year-round mean gutters and drainage lines clog continuously, not in two seasonal bursts. A blocked infiltration point backs water toward the foundation.

The Environmental Management Act governs discharges to the environment, so roof water cannot simply be dumped onto a neighbour's lot or into a storm line without checking what is allowed. The rain garden or tank has to take the whole flow, and the overflow needs a safe path.

Vancouver rewards a maintenance contract. Disconnect, then return two or three times a year to clear the system. Pricing that recurring visit is easier with the coastal, prairie and northern pricing differences in front of you.

Montreal: read the borough rule first

Montreal has no single citywide disconnection rule. Each borough sets its own requirements, so the permit and the permitted method can change when a job crosses a street. Plateau-Mont-Royal requires a permit and a site plan. Verdun's by-law allows a splash pad or rain garden as the discharge point.

Check the local rule before you quote, not after, and keep the answer in writing. The by-law is a règlement sur la gestion des eaux pluviales, and permit names vary by borough.

Older boroughs with flat roofs, exterior staircases and dense rear courtyards are the hard cases. A flat roof drains through internal leaders or scuppers, and the downspout may be shared with a neighbour or run through a party wall. That is a design problem, not a five-minute cut.

Language matters. Borough documents, permits and notices arrive in French, and homeowners expect service in French. A contractor who cannot read the borough rule or explain the work in French will misread requirements and lose jobs. The Quebec contractor guide covers the language and workplace rules.

Winter adds a constraint the other two cities do not face the same way. A downspout releasing water at grade in January builds an ice sheet on a walkway or a neighbour's property. That is a liability question as much as a drainage one, so extensions must discharge where freezing water causes no harm. Winter drainage in Canada explains the ice side of the problem.

Because the rules are fragmented, Montreal is a city to enter one or two boroughs at a time. The expansion guide covers how to add territory without spreading a crew too thin.

The three cities side by side

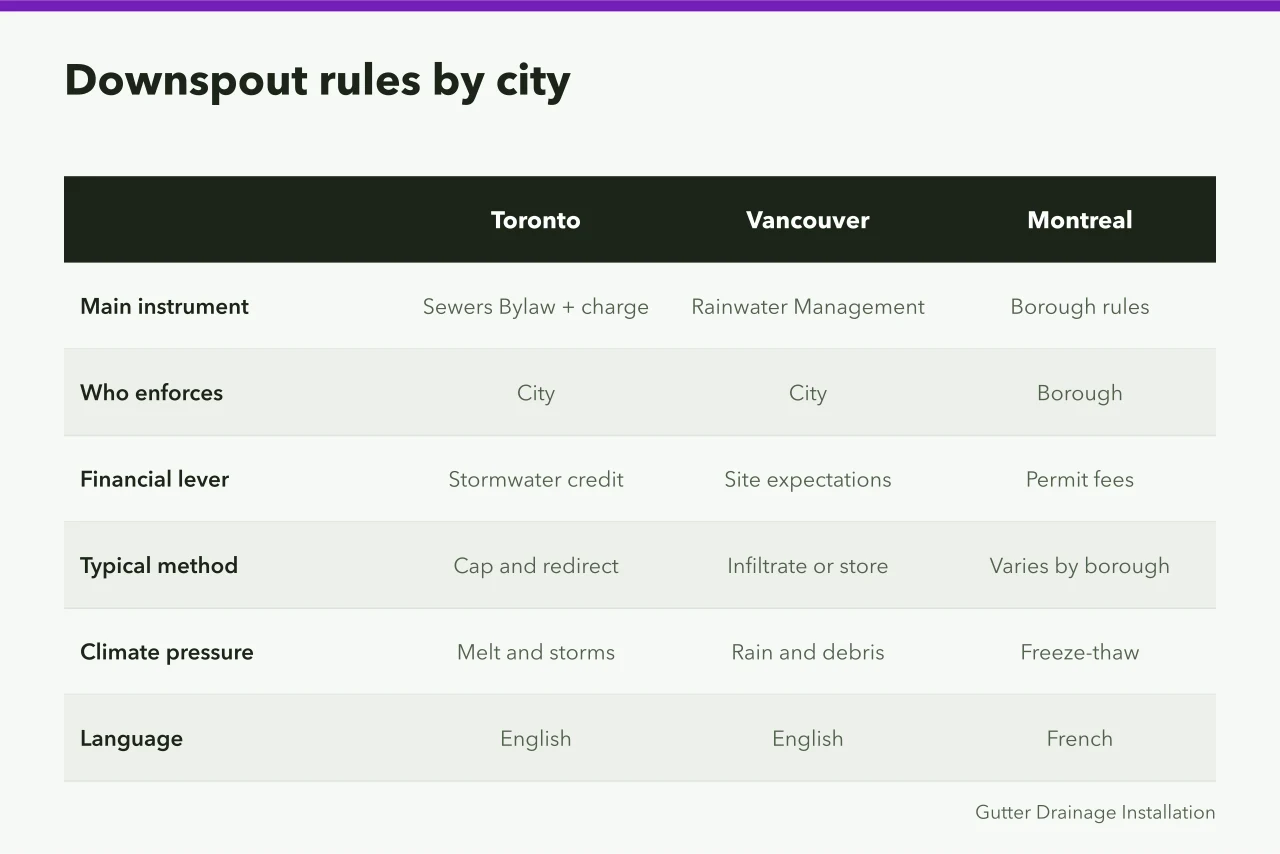

Downspout rules by city

Toronto

Main instrument
Sewers Bylaw + charge
Who enforces
City
Financial lever
Stormwater credit
Typical method
Cap and redirect
Climate pressure
Melt and storms
Language
English

Vancouver

Main instrument
Rainwater Management
Who enforces
City
Financial lever
Site expectations
Typical method
Infiltrate or store
Climate pressure
Rain and debris
Language
English

Montreal

Main instrument
Borough rules
Who enforces
Borough
Financial lever
Permit fees
Typical method
Varies by borough
Climate pressure
Freeze-thaw
Language
French

The figure and the table below set the instruments side by side. The practical point is the same in each row: the instrument, the enforcement and the method decide how much of the job is paperwork.

CityInstrumentRuleFollow-up
TorontoToronto Municipal Code Chapter 681, Sewers. A Plumbing Permit may be required.Prohibits clean roof water in the sanitary sewer.Inspection possible. Clear the system as needed.
VancouverWaterworks By-law No. 4844 and the Rainwater Management Bulletin. Plumbing Permit for alterations.Manage rainwater on site through infiltration, storage or controlled release.Rain garden and infiltration points need clearing two or three times a year.
MontrealBorough stormwater by-law (règlement sur la gestion des eaux pluviales). Permit name varies by borough.No citywide rule. Each borough sets its own requirements.Winter ice management. French-language documents. Borough inspection.

Worked example: one house, three jobs

Take a 1920s detached house with a connected rear downspout. The pipework is nearly identical in all three cities. The job around it is not.

  1. Torontoconfirm the sanitary connection, cap it, extend the downspout to a grassed or garden area, and photograph everything for the owner's file.
  2. Vancouverroute the downspout to a rain garden sized for the roof area, confirm overflow has a safe path, and set a twice-yearly clearing visit.
  3. Montrealread the borough rule first, establish whether the downspout is shared, pull the permit if required, and discharge where winter ice will not reach a walkway.

Permits, inspection risk and follow-up service separate a profitable disconnection from a callback. The pipe is the cheap part.

What the quote has to contain

A disconnection quote has four parts: site assessment, permit, materials, and follow-up. Ask for the permit fee before you quote, and do not price the job at a cleaning rate.

A cleaning rate carries none of the site assessment, the permit time or the documentation. Crews who price by the hour and forget permit time and travel between boroughs watch the margin disappear. The pricing and profit guide sets out how to build those costs into a number.

There is a compliance risk too. Reconnecting a downspout after a city has required disconnection puts the penalty on the homeowner and the reputational damage on the contractor. Written scope and dated photographs protect both sides.

What disconnection does to service demand

Disconnection moves work from a one-off repair into a maintenance relationship. A connected downspout can be ignored for years. A disconnected one ends at grade, in a garden or in a tank, and every one of those endpoints can clog, freeze or erode.

Expect more calls for downspout extensions, splash pads, rain barrels, buried drainage repair and regrading alongside ordinary cleaning. Each is a separate line item with its own material cost.

Across all three cities the direction is the same. Cities want roof water out of the sewer, and contractors who learn the local rule and document the work hold onto one of the steadier revenue lines in drainage.

Common questions

Can I disconnect my own downspout in Toronto?

Often yes, if the connection is capped properly and water is redirected safely. Photograph the work, and confirm the requirements with the city before you start.

Does Vancouver require a rainwater management plan for a single house?

Not always. Smaller lots are usually handled through on-site infiltration or storage. Larger or more complex sites may need a plan showing how runoff is managed across the property. Ask the city whether your site falls into the second group.

Why do Montreal rules differ by borough?

Boroughs hold local powers over permits and nuisances, so each sets its own disconnection requirements. A method accepted in one borough may be refused in the next. Check before quoting, and keep the answer in writing.

What should the dated photographs show?

The capped connection, the extension and the discharge point, each with the date. They are the proof that the work was done as the scope described.
