How to Build Gutter Service Pricing From Your Own Costs

Gutter service pricing from your own costs: one unit per work type, the estimate visit, the loaded crew hour, and the fascia and margin clauses.

What to take away

  • No national price per foot exists. Rainfall, wages, housing stock and discharge rules differ by state and province, so only the method travels.
  • Build a loaded crew hour before you quotewage, employer burden, insurance, vehicle and overhead, divided by the share of paid hours that are productive.
  • Hold one unit per work type. Formed runs per foot, downspouts per drop, cleaning per visit.
  • Name the fascia contingency and the on-site re-measure in the quote, with a basis and a ceiling.

Why no national price per foot holds

A foot of gutter is a commodity only on paper. What you sell is a foot installed at a specific height, under rules written by a specific city or province.

Four inputs move the price of identical work between two towns. Rainfall sets the system size and the drop count. Local wages set the labor share. Housing stock sets access hours, usually the largest variable.

Discharge rules are the fourth. Some cities require roof water to reach a storm sewer, a dry well or a rain garden instead of the foundation drain. Ontario regulates water taking under the Water Resources Act.

In the United States, the frame around discharge is the Clean Water Act's municipal stormwater permitting, run by the states with the Environmental Protection Agency. Check your city's rule before you price the discharge line.

Permits and bonding land differently everywhere, so what your jurisdiction requires belongs in your overhead before you price a job.

The Bureau of Labor Statistics publishes occupational employment and wage estimates by area. Treat it as a check on your payroll, not your price.

What fair has to mean

Fair is not cheap and it is not splitting the difference. It means the customer can see which quantities drove the number, the conditions that would change it are named before work starts, and a different estimator would produce the same price.

The units that carry each job type

Cost behaves differently in each part of this trade, so the unit must match the driver.

Work typeUnitWhat sets the quantityWhat owners miss
Formed installationPer foot, plus per dropRun length, profile, elevationAccess hours climb faster than footage
Repair and re-hangPer named task or per hourFascia condition, hanger type, reachThe board behind the hanger
CleaningPer visitCanopy, roof pitch, number of levelsDebris disposal and the second visit customers expect

Mixing units is the most common way a profitable quote becomes a loss.

Pricing Unit by Work Type

Work type

Formed runs
Per foot
Downspouts
Per drop
Cleaning
Per visit

Unit

Formed runs
Scales with length
Downspouts
Fixed sequence
Cleaning
Driving dominates

Why

Formed runs
Downspouts
Cleaning

A cleaning job quoted per foot loses money on every small ranch house. An installation quoted per visit loses money on every long run. Canadian line items often separate eavestrough from downspout. Formed runs also carry the machine and the trailer, so what your equipment setup does to a schedule sits in the hourly cost, not the per-foot rate.

The estimate visit, in order

  1. Walk the perimeter first. Note elevations, ground conditions and where each run terminates.
  2. Measure each run and count the corners. Corners are labor, not length.
  3. Count and locate the drops, including any the system misses.
  4. Follow the water to its terminal end, including any buried line.
  5. Press the fascia at the low points and at every downspout.
  6. Photograph the fascia and the discharge point.
  7. Ask what prompted the call. Listen for basement, ice or overflow.
  8. Write the observations at the property, not later.

Leave with four quantities and two photographs.

  • Run length and corners, measured.
  • Drop count and height, counted at each termination.
  • Access class, from ground, elevation and obstruction.
  • Fascia condition, pressed by hand.

Define three written classes before estimating: standard access means level ground and a clear setup area; restricted access means a slope or obstruction that slows setup; difficult access means elevation or multiple obstructions that limit setup. Apply the class consistently and use completed-job records to assign its hours.

Turning quantities into hours

Convert quantities into hours before you convert hours into money. That step is where access difficulty enters the price.

Attach a time from completed-job records to each quantity: forming and hanging per foot at each access class, time per drop, time per corner, setup and teardown per elevation, and travel. Add a fixed allowance for verifying measurements before forming, because a remeasure is a return trip with the trailer.

Building the loaded crew hour

The number that matters is the loaded cost of a crew on a roof.

  1. W is the wage you actually pay, not a posted range.
  2. E is employer burden: payroll taxes, workers compensation, unemployment insurance and health contributions.
  3. I is the per-hour share of general liability and related policies.
  4. V is vehicle cost per productive hourtruck, trailer, fuel, maintenance, depreciation.
  5. O is overhead per productive houroffice, software, phone, estimating and selling time.
  6. Divide the total by U, the share of paid hours that are productive on a roof.

Loaded hour = (W + E + I + V + O) / U

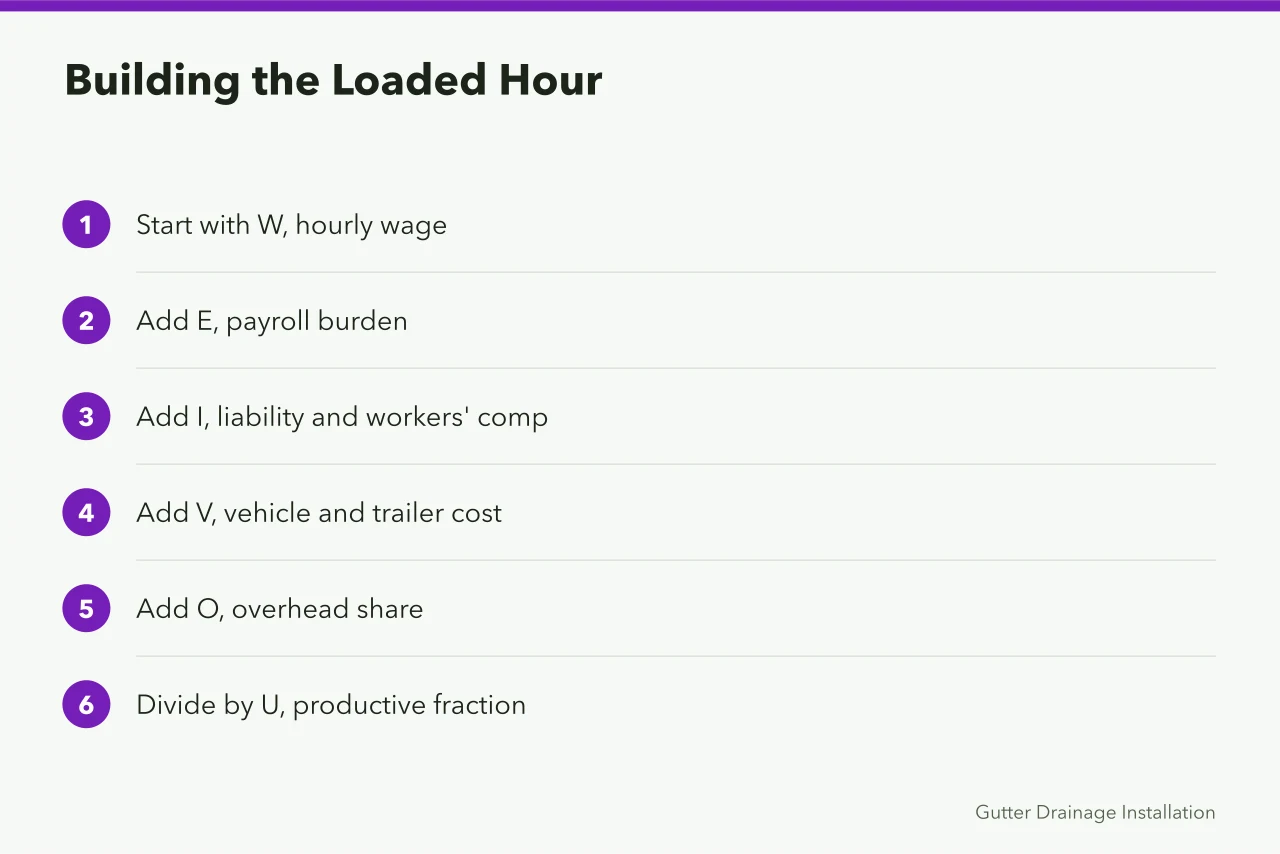

Building the Loaded Hour

  1. Start with W, hourly wage
  2. Add E, payroll burden
  3. Add I, liability and workers' comp
  4. Add V, vehicle and trailer cost
  5. Add O, overhead share
  6. Divide by U, productive fraction

Travel, setup, supply runs and weather downtime are paid and not billable. A crew paid for 40 hours that produces 26 has a U near 0.65.

Why identical footage prices differently

Two houses, each with 180 feet of run and four drops. The first has a walkable 4/12 roof and a driveway wide enough for the trailer. The second has a 9/12 roof, a dormer and a fenced side yard.

The first job clears in a morning. The second takes the day, and no difference in footage explains it. Access hours do.

Set an access factor from completed-job records, comparing estimated and actual hours by access class; adjust it when the records show a consistent miss. Use unit economics for owners to keep that comparison in the job-cost review.

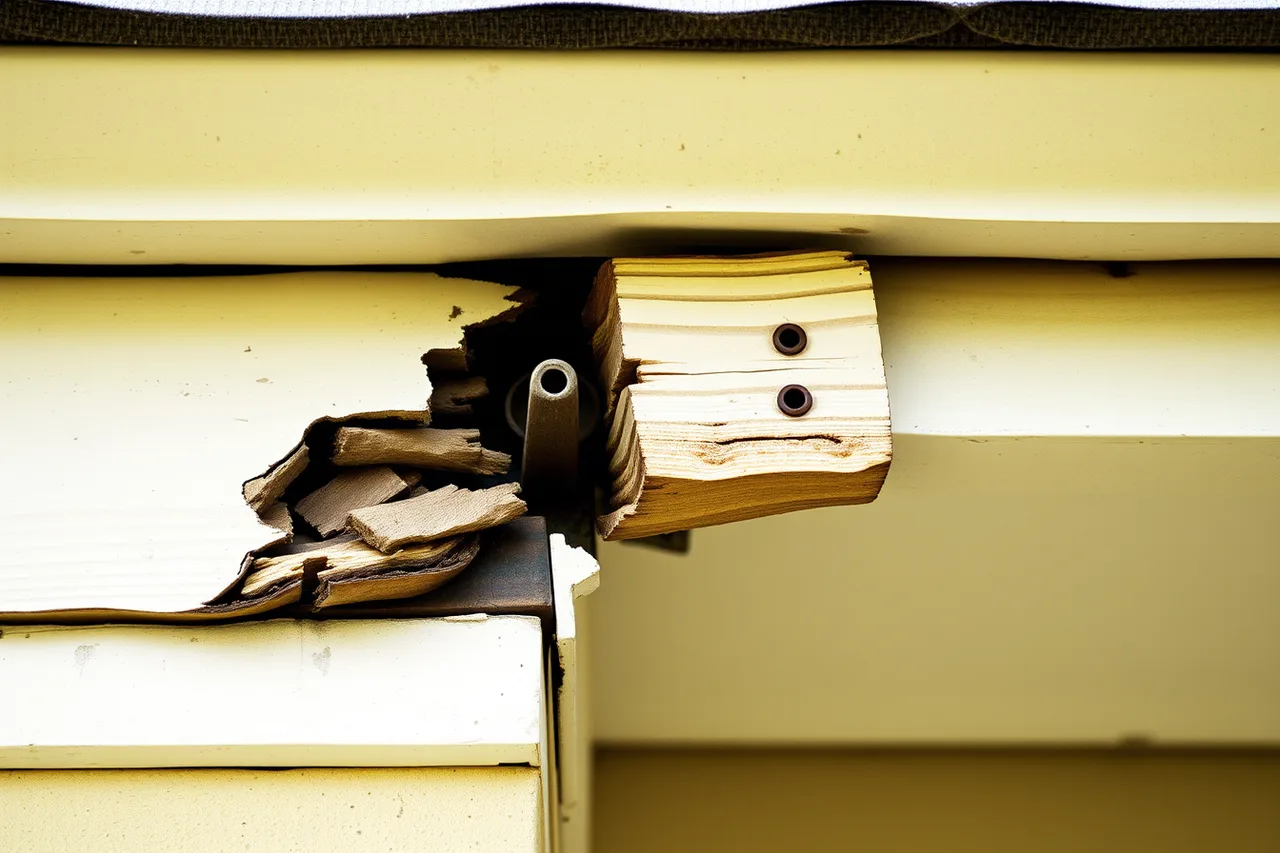

The fascia contingency and the re-measure clause

A hanger holds because the fascia holds. Soft board and old spike holes are common, and none can be judged from the ground.

State a written unit and ceiling in advance: “Fascia replacement is not included in this quote. If needed, it will be billed at the per-foot or hourly rate stated in the schedule attached to this quote, up to the ceiling stated there. We will get approval before exceeding that ceiling.” Fill in the rate and ceiling before the customer accepts; don't leave a blank in a signed quote.

State the re-measure fee and scope in the quote: “On-site re-measurement before forming costs the fee stated in this quote and must be approved before we schedule it.” Enter the actual fee and obtain approval before scheduling.

If the customer changes scope afterward, that is a change order. If you changed it, that is your cost.

The margin decision is made once, not per job

Choose a target gross margin from the business's cost structure and profit goals, then divide each job's cost by the share of revenue left after that margin to set its price. Apply the same target consistently across quotes and compare realized job results with it.

A sent quote goes wrong for the same reasons. The customer cannot see which quantities drove the number, so they shop on price. The contingency has no basis or ceiling, so extra work becomes an argument. The remeasure was never a paid step, so the return trip is your cost.

What an advertised price must disclose

A headline price is a claim, and claims carry conditions. The conditions that make the number achievable must be clear enough for a reader to understand, and the offer has to be genuinely available. The Federal Trade Commission's advertising guidance for small businesses sets out that expectation.

Three habits draw complaints: a per-foot headline that hides drops, a cleaning rate that assumes one story, and a price no crew is ever scheduled to honor.

State what sits inside the number and what conditions change it; use the packages and pricing structure to present those terms consistently.

Common questions

How do I find local wage and burden figures?
Start with the Bureau of Labor Statistics area estimates for the occupation, then use your payroll register for burden. Your workers compensation rate card supplies the insurance share.
Should steep access be priced per foot or per hour?
Per hour. Access changes how long a foot takes, so loading it onto a linear rate distorts every ordinary quote.

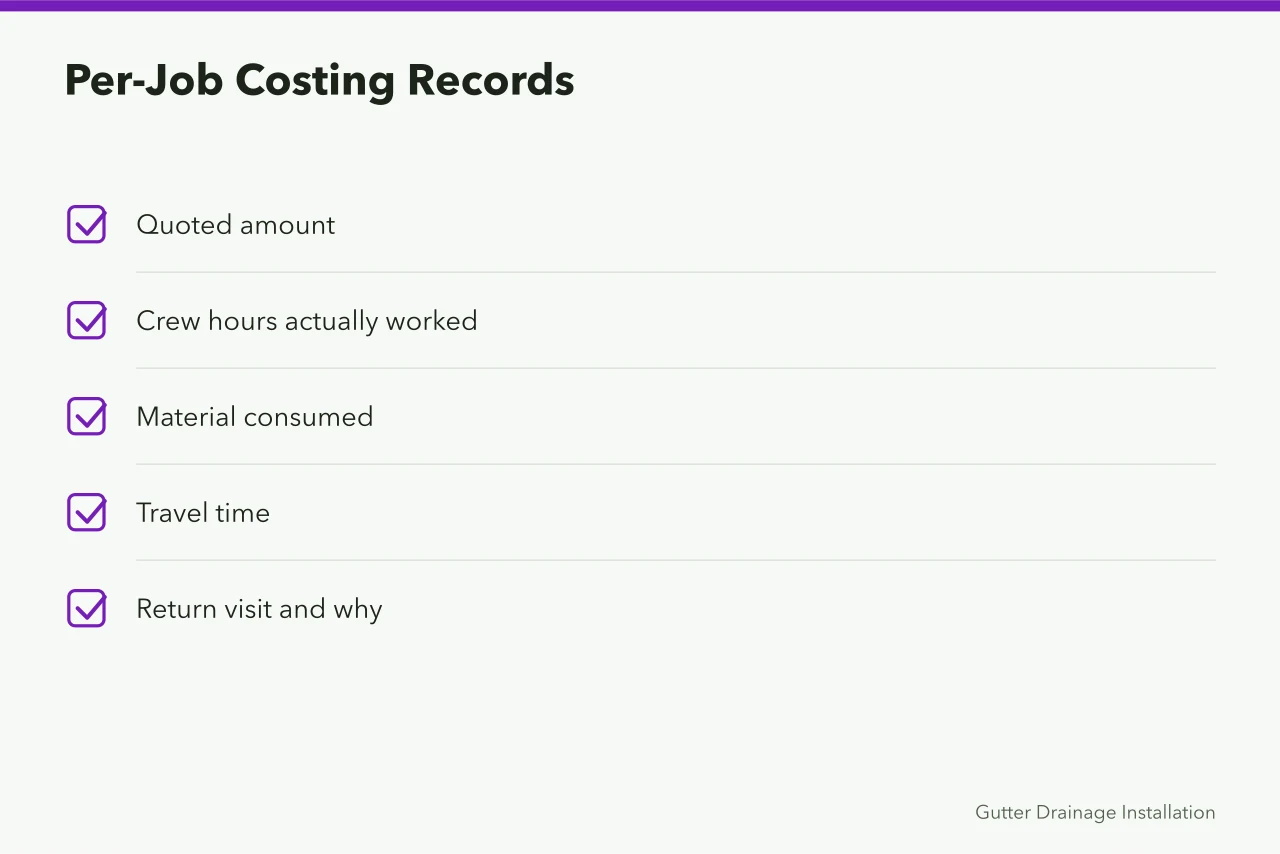

How do I know the price was right after the job?
Record quoted amount, crew hours worked, material used, travel time and every return visit with its reason. Compare realized hours against the hours you priced with, monthly rather than annually.
When should I re-price?
Whenever wage, insurance or coil prices move, and at least once before the 2027 season opens.
